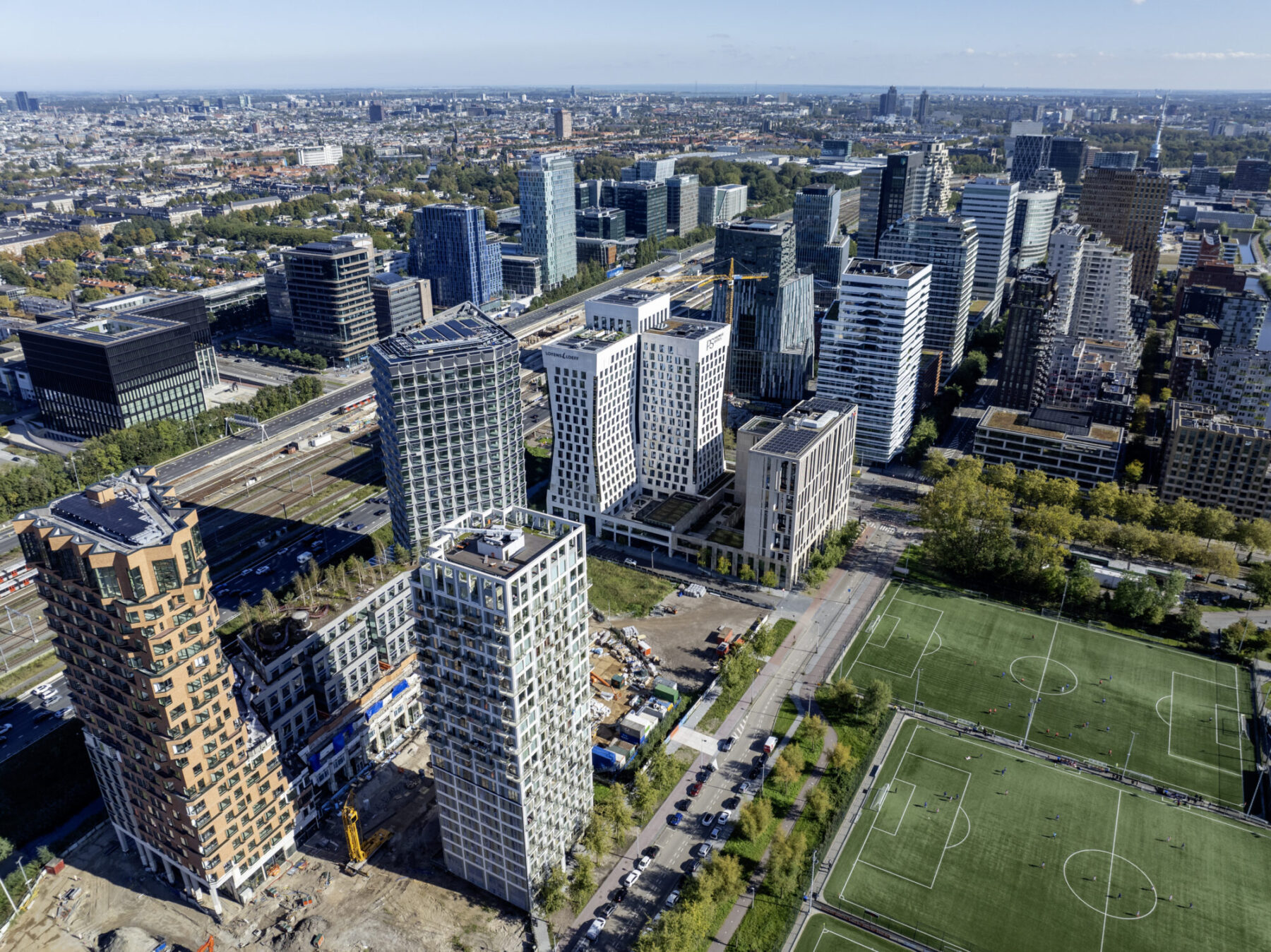

Construction hoardings have already been installed on the plot next to The Pulse of Amsterdam, and foundation works will begin in mid-April. One year later, around April 2027, residential building Benten is expected to be ready for occupation. Project manager Niek Kerkhof Jonkman of Plegt-Vos explains how 127 social housing units can be delivered within a year: ‘The key is industrialised construction.’
Industrialised construction

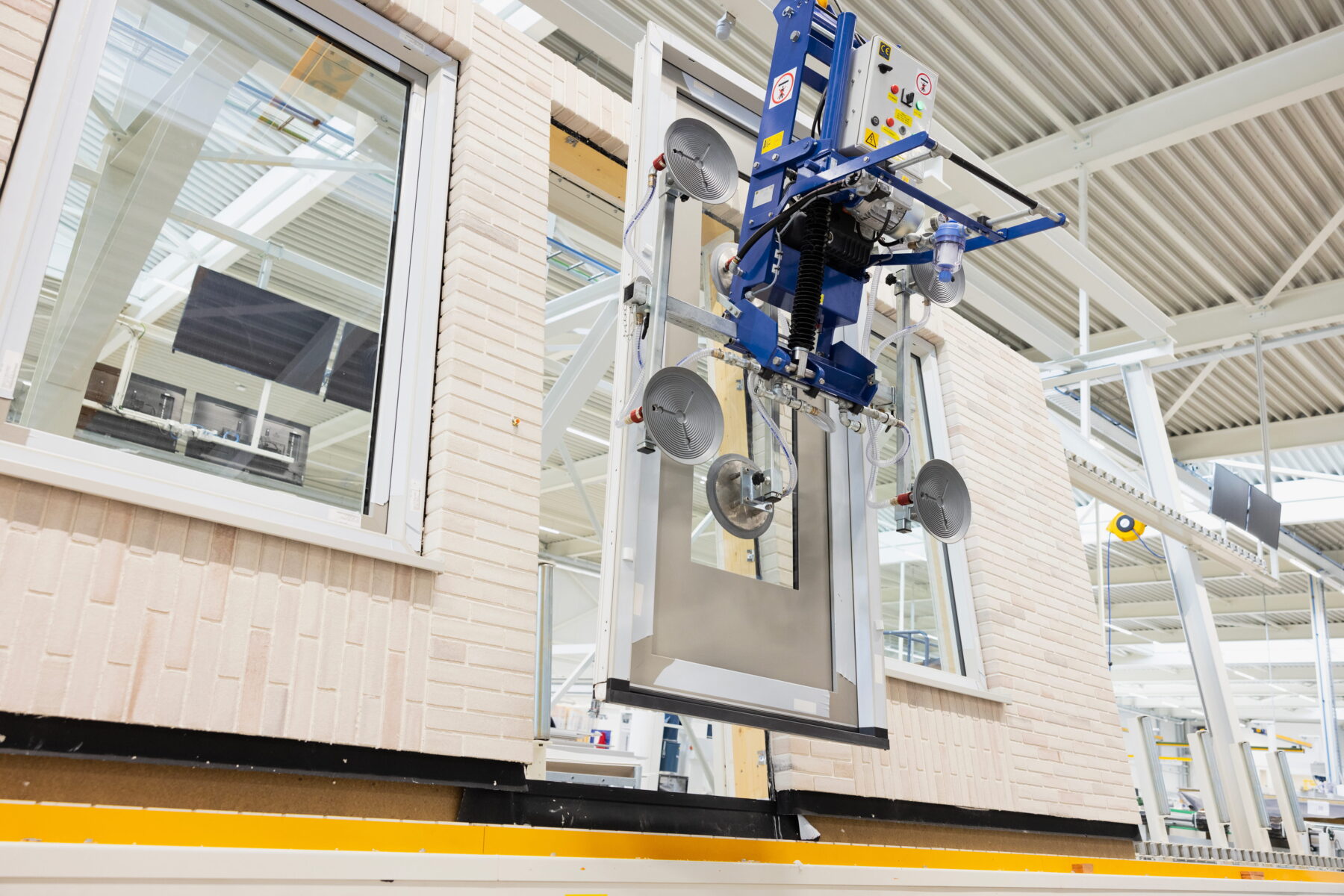

This means that residential building Benten will consist of various components produced in advance at Plegt-Vos’ Smart Housing Factory (Slimme Huizenfabriek). Kerkhof Jonkman explains: ‘We manufacture the bathrooms entirely ourselves. We assemble them into fully equipped bathroom modules, right down to the toilet roll holder. On site, everything only needs to be installed. We believe this approach – industrialised construction – is the answer to the growing demand for fast, sustainable and affordable housing.’
Consistent and predictable quality
Because much of the work takes place indoors, weather conditions are no longer a major factor: ‘At temperatures of minus 10 degrees Celsius, for example, you cannot lay tiles on site. In the factory, temperature and weather are never an issue. Working under controlled conditions allows us to deliver consistent and predictable quality.’ According to Kerkhof Jonkman, there is another advantage: ‘On a worksite, you usually only hear music and whistling when the weather is good. In our factory, you hear that all year round.’
Faster construction

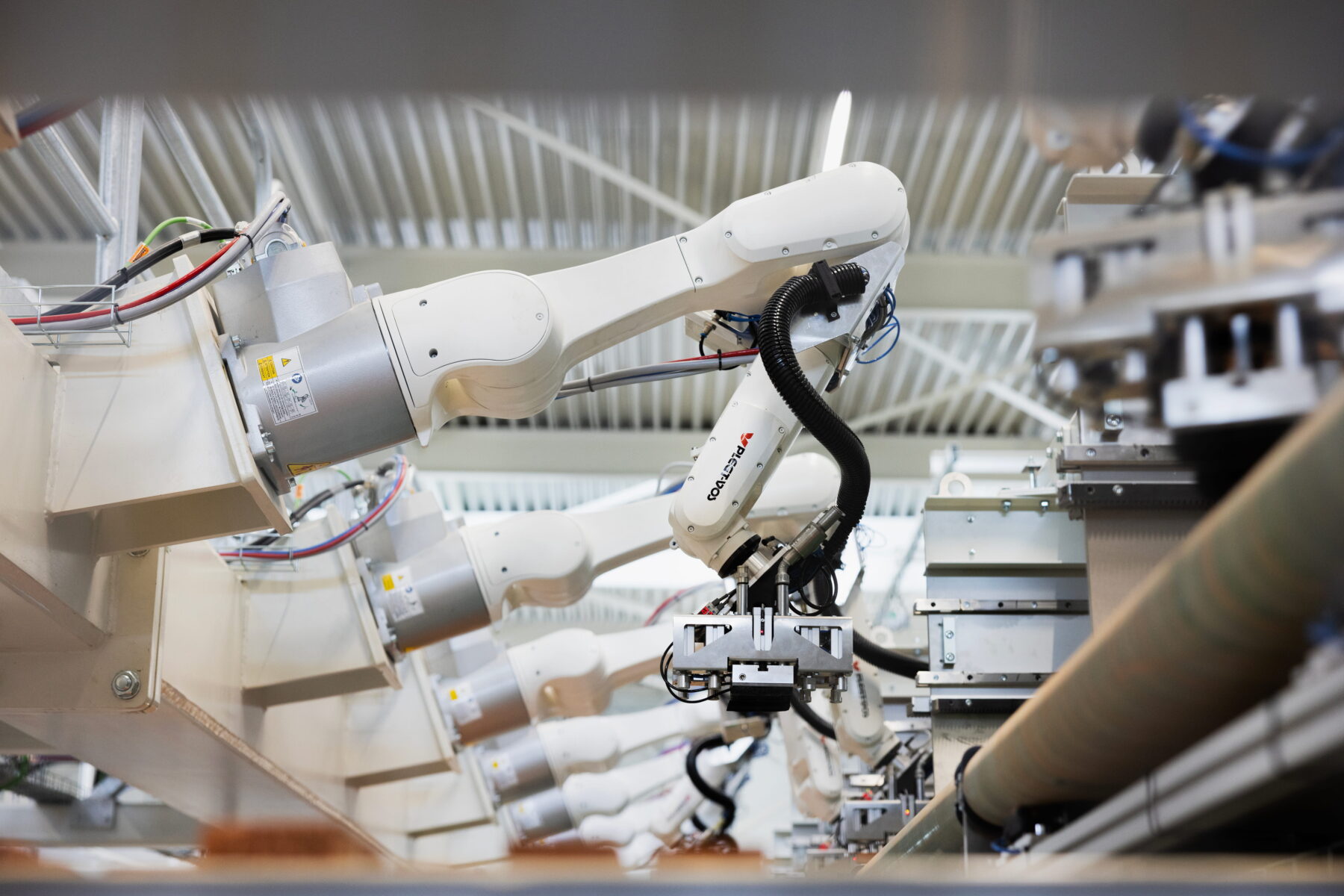

Much of the work is also automated. This is particularly valuable at a time when skilled technical staff are in short supply, says Kerkhof Jonkman: ‘Productivity also increases significantly, as robots continue working during breaks and after 17.00.’ This enables faster construction. ‘Using traditional methods, the construction of Benten would take around a year and a half’, says Kerkhof Jongman. ‘With industrialised construction, we reduce that to approximately one year. That is quite something at a time when students are struggling to find housing.’
Sustainable
Factory-based production also reduces CO2 emissions, thanks to fewer transport movements (everything is produced in one location) and less waste (due to precise, automated construction). In addition, residential building Benten will feature prefabricated timber-frame walls and window frames produced by Plegt-Vos from FSC-certified timber. ‘These are renewable materials that have been sustainably produced’, Kerkhof Jonkman explains. Additionally, because much of the construction is completed in the factory, fewer workers are required on site.
Name and schedule
The name ‘Benten’ is inspired by the Japanese goddess of knowledge, wisdom, art and fortune, which reflects the character of the Kenniskwartier district. The construction of the 127 student homes is scheduled as follows:
- February 2026 – mid-April 2026: Installation of construction hoardings and excavation of the construction pit
- Mid-April 2026 – early July 2026: Installation of pile and beam foundations
- Early July 2026 – February 2027: Structural works and façade construction at a rate of 10-15 days per floor (nine floors in total)
- December 2026: Highest point reached
- September 2026 – March 2027: Finishing phase and completion
