Ideally, the kilometre-long tunnel would be built consecutively bit by bit, in around 40 sections 25 m to 30 m long and 30 m wide. That works the fastest. ‘But in this busy area, it’s important that the station and surrounding buildings always remain accessible’, says Frank Schuitemaker from construction firm VolkerWessels. ‘That’s particularly challenging on the narrow north side of the station. Having a 30 m wide construction pit there would swallow up all the public space. So we’ve come up with a different solution.’
Narrower construction pit
To the north of the station, where the traffic heads west in the direction of the De Nieuwe Meer junction, we are therefore dividing the tunnel into two long, narrow strips roughly half of the width. We are first building the half on the side where the office buildings, such as the WTC, are. When that has been completed, the kilometre-long strip alongside the tracks will follow. According to Schuitemaker, phasing the work in this way has its advantages: ‘As a result of this, the construction pit is only half as wide and there’s enough space left over during construction for users of the area and our own logistics.’
Two tunnel tubes

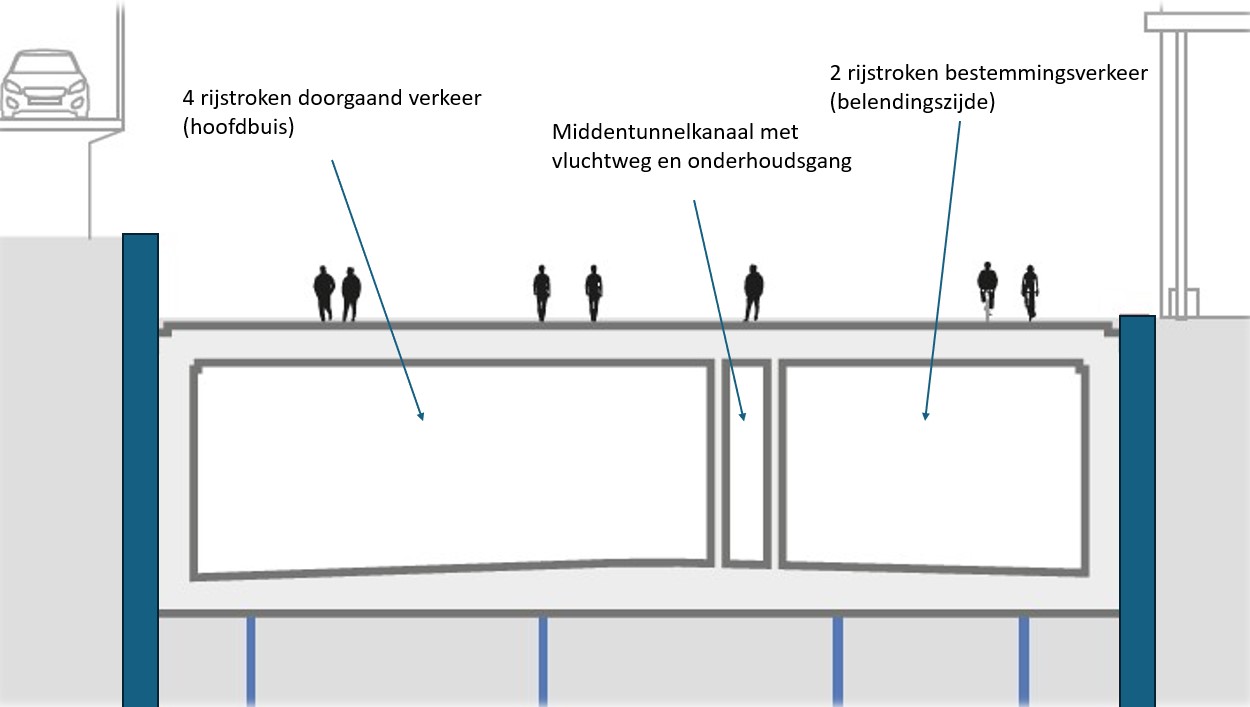

The reason why we are starting to build the tunnel on the side adjacent to the office buildings is because of the structure of the tunnel. It consists of a main tube with four lanes on the station side, a central tunnel channel with evacuation route and maintenance corridor and a narrower tube in which there will be two lanes for local traffic. In other words, several ‘tunnels within a tunnel’. We are starting construction on the central tunnel channel and the tube for local traffic on the side adjacent to the office buildings. This is because the central tunnel channel will also need to support the roof of the main tube with four lanes. This is why that main tube can only be built later.
Open construction pit

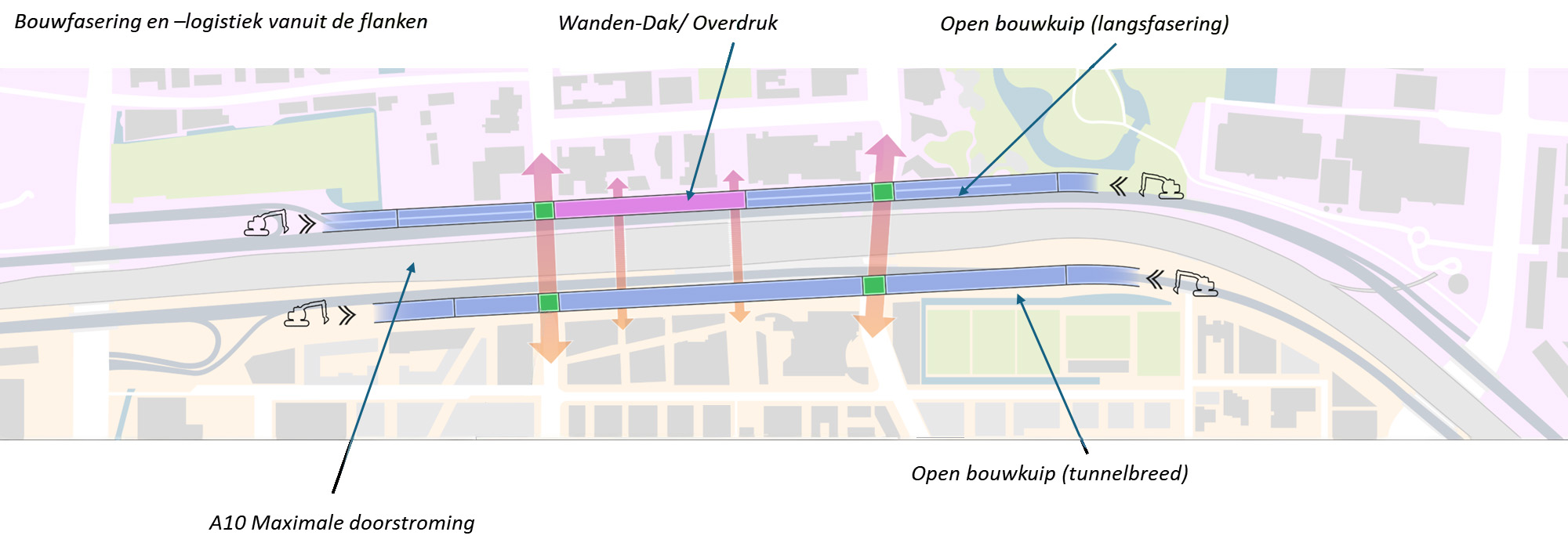

So, we are beginning work on the construction of the tube with lanes for local traffic. How do we plan to do that? As stated earlier, we are building the tunnel in sections of 25 to 30 m in length. This means we will not be building a single construction pit that is a kilometre long, but instead will be working in compartments (several sections bundled together), each of which will be tens of metres in length. In each compartment, we will then build the tunnel from the bottom up to the top, from floor to roof. The ‘open construction pit method’ is relatively simple and we are applying it on both sides of Amsterdam Zuid station. However, according to Schuitemaker, that is not the whole story when it comes to the narrow north side of the station.
Construction pit with a roof

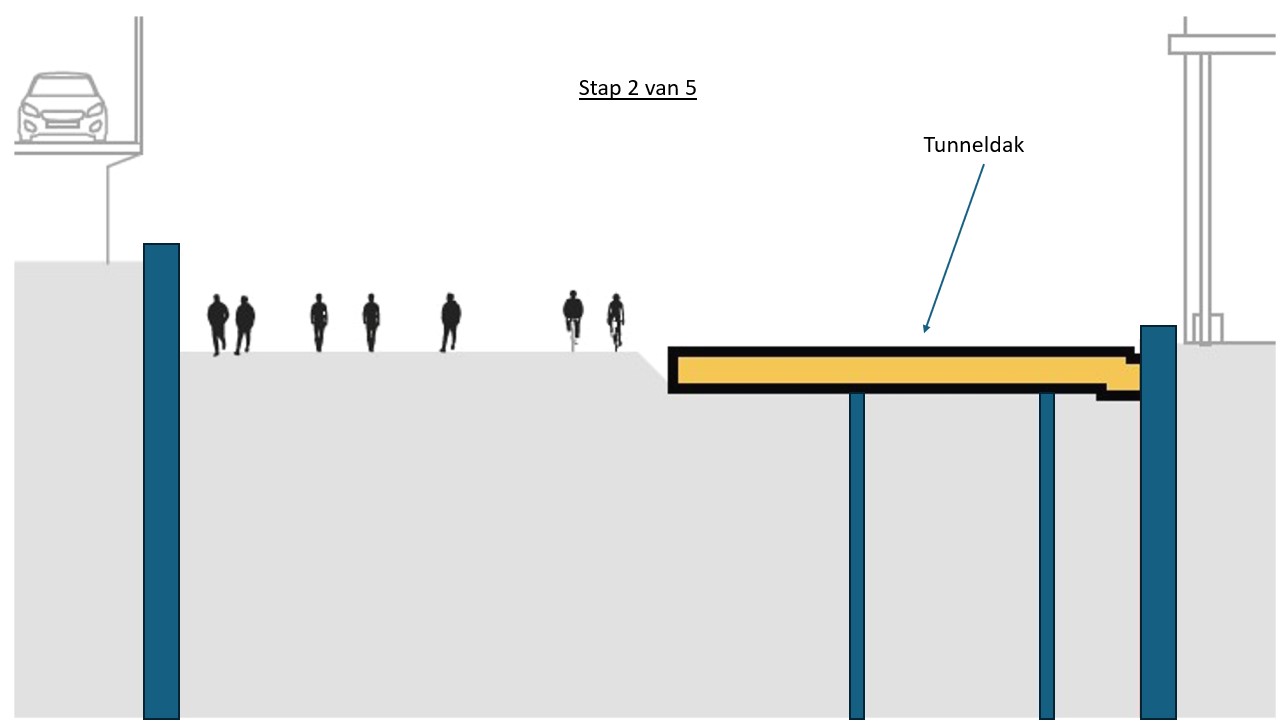

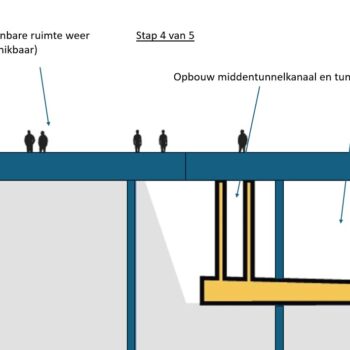

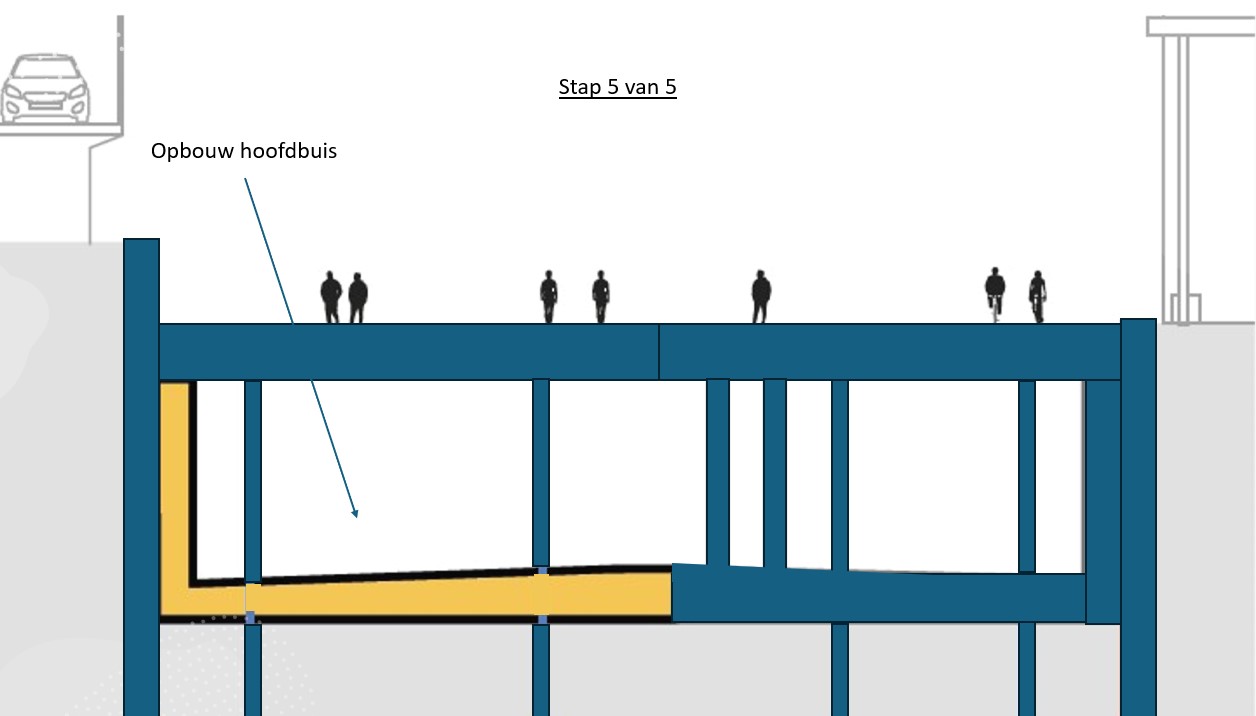

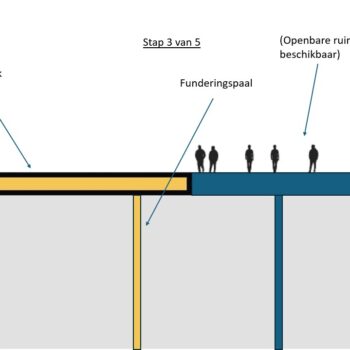

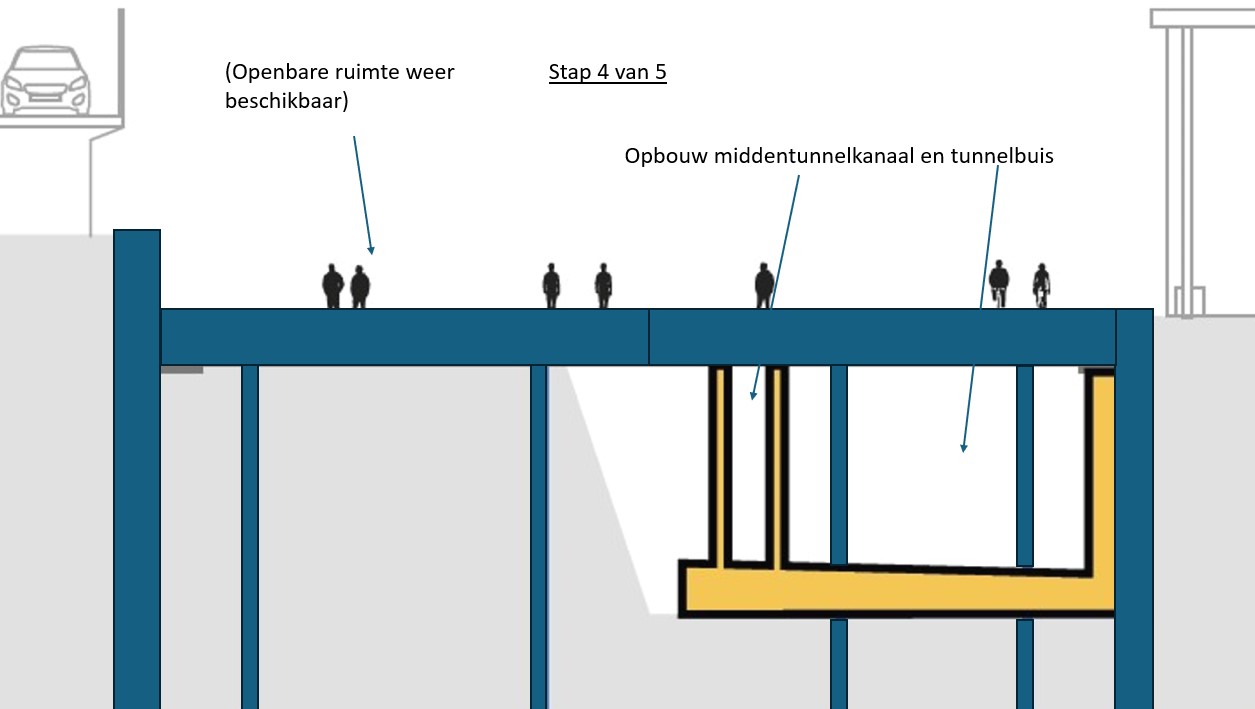

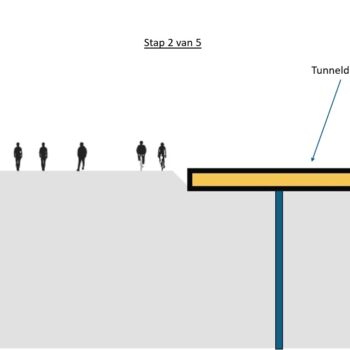

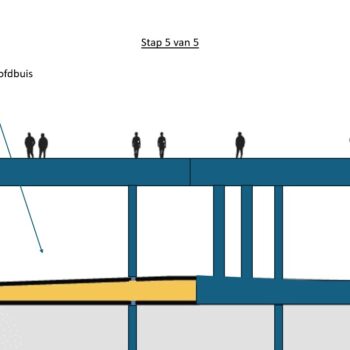

There is only limited space there, especially between Parnassusweg and Zuidplein. This will create challenges when the existing entrance to the station is being thoroughly renovated starting in 2027 and the new Brittenpassage is being used instead. We also plan to apply the ‘walls-roof method’ there. Schuitemaker: ‘In that case, we won’t be digging a construction pit, but will first build the tunnel walls and insert foundation piles into the ground. We will then build the roof on top of that, enabling pedestrians to make use of the street above it while we continue to dig the tunnel underneath and build up the tunnel floor and walls’.
Giving back space

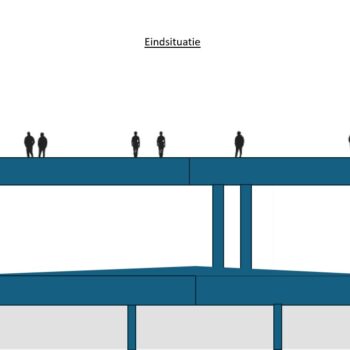

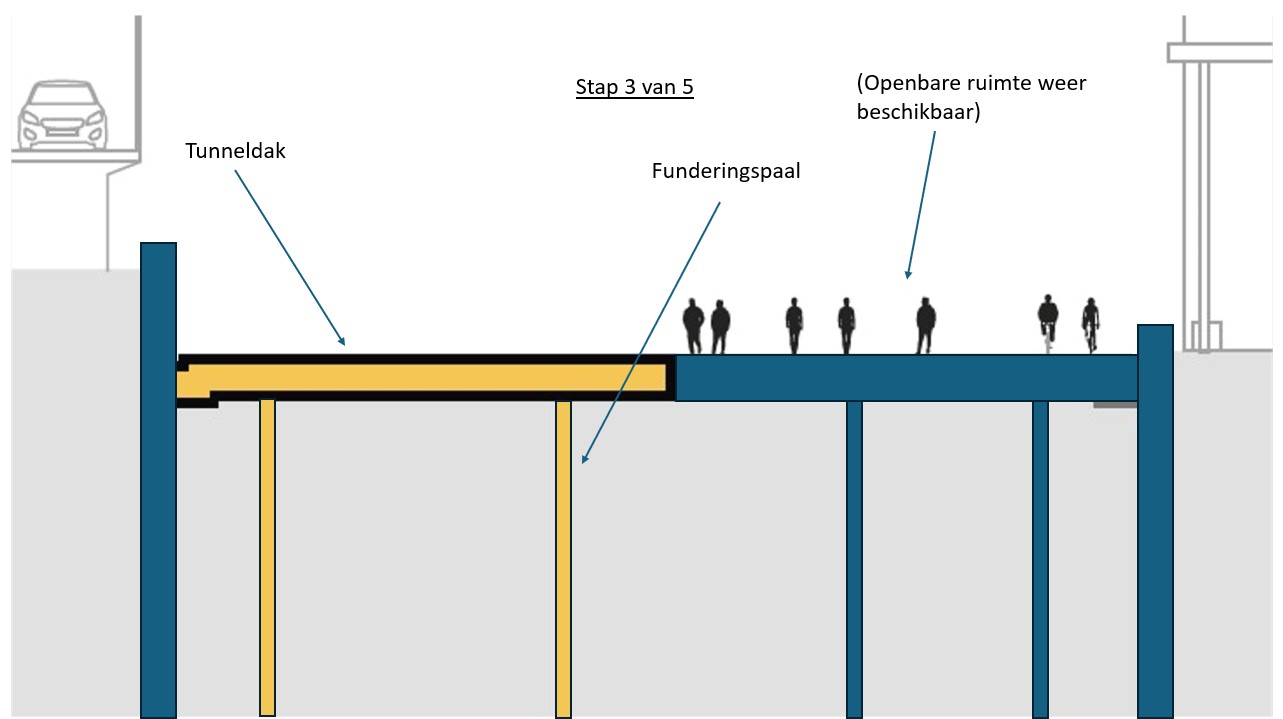

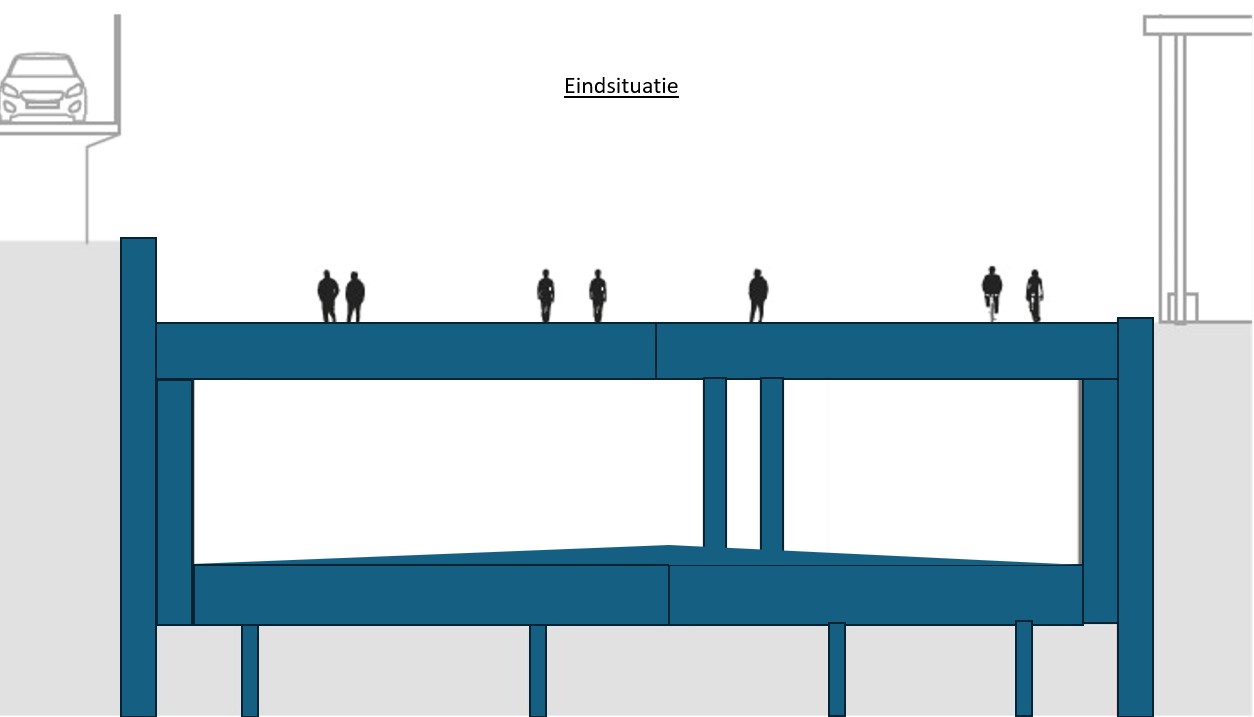

However, this method is more complex than the open construction pit method. ‘In order to ensure that the groundwater stays out of the excavation zone at a depth of around 10 m, the work space must be kept under pressure throughout the works. This means that our colleagues will need time to be able to move safely from the high-pressure atmosphere underground to the normal pressure aboveground, similar to the situation for divers. That makes it an expensive technique. On the other hand, every time we complete a section of roof, we can very rapidly give back a piece of public space to the travelling passenger.’
